CYCLE OF OPERATION :
An effective cycle depends on the equipment used, the management of labour and careful planning of sets. A typical 9 day cycle can be achieved as follows :

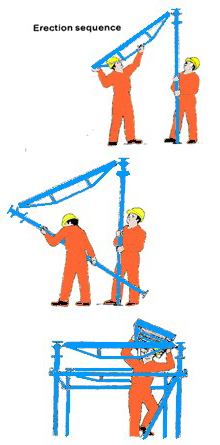

Day 1 Commence erection of formwork.
Day 2 Continue formwork erection and commence fixing of steel.
Day 3 Complete formwork and continue steel fixing and commence electrical conducting.
Day 4 Complete steel fixing and electrical work.
Day 5 Pour concrete.
Day 6-8 Curing time for concrete.

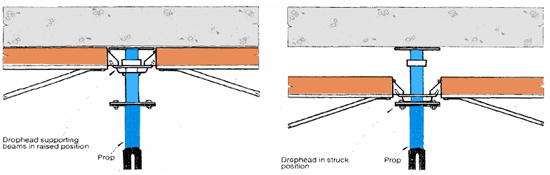

Day 9 Quick strip the formwork and start cleaning formwork for erection next day.
|
